Move to Production & Down Alignment
Presentation
Purpose
Using a Move to Production approach ensures that the exact same module, already tested in Development and Staging environments, is deployed to Production. This guarantees consistency and reduces the risk of environment-specific bugs.
Using a Down Alignment approach ensures that lower environments reflect the state of Production.
A manual Down Align (Production to Development) can be triggered on demand when developers need to mirror Production to debug, reproduce issues, or validate changes.
An automatic Down Align (Production to Staging) is systematically performed before any Staging deployment. It ensures Staging is always a clean, up-to-date Production replica, enhancing confidence in pre-prod testing.
Prerequisites
These features are available only if all the following conditions are met:
Self-Services are configured in the Hopex Cloud Portal by Mega Cloud Services (MCS).
Your organization uses the Enterprise SaaS offer (not available with the Essential offer).
You are logged in as a Delegated Administrator.

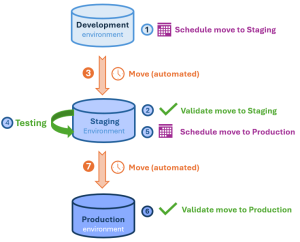

Move to Production
Procedure Overview
Action
Environment
Remarks
Development

Staging

Moving to Staging Process
(Automated)
May take several hours
Includes an automatic Down Align from Production to Staging
Testing Staging
Staging
Recommended:
Test your Staging environment before scheduling the Move to Production
Staging

Production

Moving to Production Process
(Automated)
May take several hours

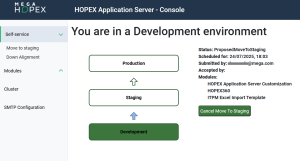

Scheduling a Move to Staging
From the Development environment, you can schedule a Move to Staging.
*The scheduled Move to Stating must then be validated from the Staging environment to be executed.
To schedule a Move to Staging:
1. Access the HAS console of your Development environment.
2. In the navigation bar, select Self-service > Move to Staging.

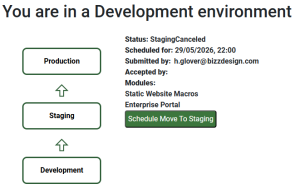

In the diagram, Development is not colored: a Move to Staging is not planned.
*Status and characteristics of the previous scheduled Move to Staging are shown. For example here, the previous Move to Staging was canceled (Status: StagingCanceled).

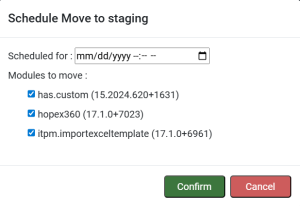

3. Click Schedule Move to Staging.

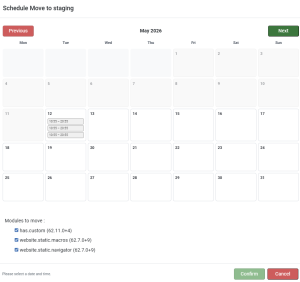

The calendar opens and shows any time slots already booked for other actions. These slots are unavailable.
*Over the cursor over a booked slot for information on the action.
4. In the calendar, click the required date.
*If needed, click to view up to 12 months ahead and select a date.
5. Use the drop-down menus (Hours:Minutes) to define the time.
(Default time: 09:00).
*The time is defined in the platform local time.
Time format: hh:mm where hh: 00-23 and mm: 00-55 (in 5-minute intervals).
6. Click Confirm.
The selected day and time are booked.
E.g.: Friday, May 29 at 22:00.
7. (If needed) Clear the module(s) you do not want to deploy yet.
By default all the modules are selected.
8. Click Confirm.
In the diagram, Development turns green, and its arrow towards Staging turns blue (proposal waiting for confirmation).
*The arrow turns black (proposal validated) once the Move to Staging is validated from the Staging environment.
The Move to Staging is scheduled and its characteristics are detailed:
Status: ProposedMoveToStaging
Scheduled for: scheduled date and time
Submitted by: submitter
Accepted by: <empty, waiting for approval>
*Filled once the proposal is validated from the Staging environment.
Modules: list of modules concerned

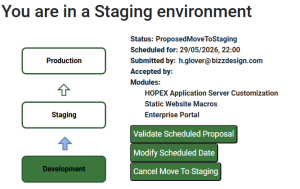

The Move to Staging is scheduled and now requires validation in the Staging environment.
Validating a Move to Staging
From the Staging environment, you must validate the scheduled Move to Staging proposal for the move process to be performed.
If needed you can:
modify the proposal (e.g.: non suitable date)
cancel the proposal (e.g.: non suitable module list)
To validate a Move to Staging:
1. Access the HAS console of your Staging environment.
2. In the navigation bar, select Self-service > Move to Production.
3. Click Validate Scheduled Proposal.

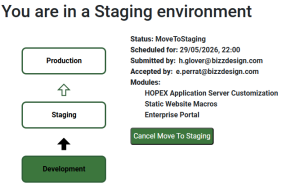

The Move to Staging is validated.
The Move to Staging process can take several hours to complete as an automatic Down Align process is first performed to synchronize the Staging environment with the Production environment current state.
Scheduling a Move to Production
From the Staging environment, you can schedule a Move to Production.
*The scheduled Move to Production must then be validated from the Production environment to be executed.
*After a Move to Staging, make sure to test the Staging environment before scheduling a Move to Production.
To schedule a Move to Production:
1. Access the HAS console of your Staging environment.
2. In the navigation bar, select Self-service > Move to Production.
3. Click Validate & Schedule Move to Production.
The calendar opens and shows any time slots already booked for other actions. These slots are unavailable.
*Over the cursor over a booked slot for information on the action.
4. In the calendar, click the required date.
*If needed, click to view up to 12 months ahead and select a date.
5. Use the drop-down menus (Hours:Minutes) to define the time.
(Default time: 09:00).
*The time is defined in the platform local time.
Time format: hh:mm where hh: 00-23 and mm: 00-55 (in 5-minute intervals).
6. Click Confirm.
The selected day and time are booked.
7. Click Validate & Schedule.
In the diagram, the arrow towards production turns blue (proposal waiting for confirmation).
*The arrow turns black (proposal validated) once the Move to Production is validated from the Production environment.
The Move to Production is scheduled and its characteristics are detailed:
Status: ProposedMoveToProduction
Scheduled for: scheduled date and time
Submitted by: submitter
Accepted by: <your identifier>
Modules: list of modules concerned
The Move to Production is scheduled and now requires validation in the Production environment.

Validating a Move to Production
From the Production environment, you must validate the scheduled Move to Production for the move process to be performed.
If needed you can:
modify the proposal (e.g.: non suitable date)
cancel the proposal
To validate a Move to Production:
1. Access the HAS console of your Production environment.
2. In the navigation bar, select Self-service > Production Deployment.
3. Click Validate Scheduled Proposal.
The Move to Production process can take several hours to complete.
Down Alignment

Scheduling a Down Alignment
You can schedule a Down Alignment to synchronize the Development environment with the current state of Production.
If needed you can cancel the scheduled down alignment.
To schedule a Down Alignment:
1. Access the HAS console of your Development environment.
2. In the navigation bar, select Self-service > Down Alignment.
3. Click Schedule Down Align.
The calendar opens and shows any time slots already booked for other actions. These slots are unavailable.
*Over the cursor over a booked slot for information on the action.
4. In the calendar, click the required date.
*If needed, click to view up to 12 months ahead and select a date.
5. Use the drop-down menus (Hours:Minutes) to define the time.
(Default time: 09:00).
*The time is defined in the platform local time.
Time format: hh:mm where hh: 00-23 and mm: 00-55 (in 5-minute intervals).
6. Click Confirm.
The selected day and time are booked.
7. Select what you want to synchronize from Production to Development:
SystemDB repository and files configuration: this refers to the configurations of the modules.
Data repositories (Anonymization): data from your repositories is anonymized
8. Click Confirm.
The Down Align process is scheduled and its characteristics are detailed:
Status: Scheduled
Scheduled for: scheduled date and time
Submitted by: submitter
detail of synchronization
